Strong collaboration and leadership results in successful 500kV project energization
Features | Jakarta, Indonesia | 15.06.2020 | 3 min read
Features | Jakarta, Indonesia | 15.06.2020 | 3 min read
Following the success of energizing the 500 kV substation project in Lengkong on August 2019, the first ever by the ABB Power Grids Indonesia team, Grid Integration and Grid Automation teams once again, worked relentlessly to complete the installation and commissioning of diameter 5 and 6 of the extension projects of 500 kV Bandung Selatan substation. Adding one more feather in its cap!

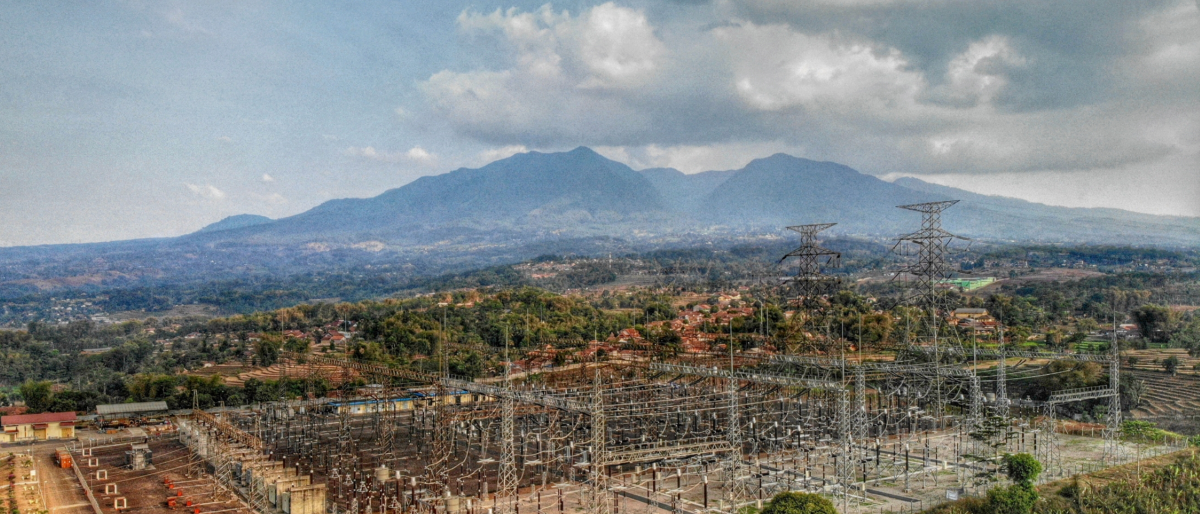

This state-the-art 500 kV substation in South Bandung has a key role to play, connecting the 500 kV backbone transmission lines from North to Southern Java as part of the State Electricity Company PLN efforts to strengthen and mitigating bottlenecks in the grid and increase its reliability.
Thanks to the superior synergic approach, wherein the two teams put in their respective core competencies to ensure smooth delivery and successful commissioning of the project, despite challenging circumstances due to the COVID-19 crisis and project minor issues.
How we did it:
The development project has been managed by one of the implementing units of PT PLN (Persero) UIP JBT II, UPP JJBT, 1 and it has expanded to 500 kV GITET in South Bandung which originally was 4 diameters 500 kV to 6 diameters 500 kV.
This extension project, energized on 30 April 2020, comprises of 3 bay lines – Bay line 500 kV New Saguling 1 Future, Bay line 500 kV New Saguling 2 Future, and Bay line 500 kV Depok in 500 kV South Bandung substation. Previously, PT PLN (Persero) Certification Center carried out individual and equipment testing, while also declaring worthy of tension for 24 hours loading experiments.
Kudos to the entire team deserving this recognition for their tireless work ethics and strong commitment to the customer as well as towards HSE.
